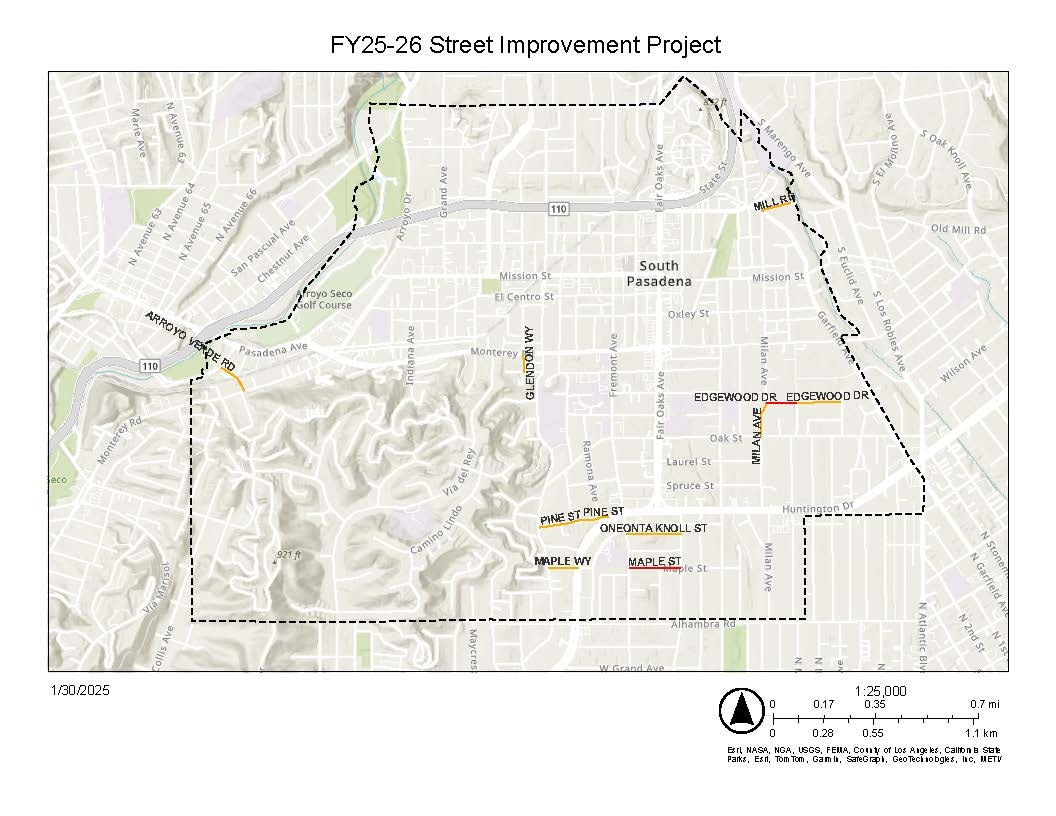

| PROJECT DESCRIPTION |
The FY25-26 (formerly FY19-20) Street Improvement Project will deliver pavement rehabilitation, water and sewer line upgrades, and sidewalk and curb repairs on multiple streets. Projected start date September 22, 2025.
The City of South Pasadena and Gentry Brothers, Inc. thank you for your cooperation, patience and support while we work to improve our community.
|
TIMELINE
|
Monday - September 29, 2025 |
Projected Start Date
- City will commence the project.
|
| September 2025 - April 2026 |
Water Improvements
- Water main Line
- Water Meters
Impacted Streets
| Edgewood Drive |
October 13, 2025 - February 13, 2026 |
| Milan Avenue |
November 10, 2025 - February 20, 2026 |
| Oneonta Knoll St |
November 10, 2025 - February 20, 2026 |
| Maple Street (East) |
January 12, 2026 - February 20, 2026 |
| Pine Street |
February 9, 2026 - March 13, 2026 |
| Maple Street (West) |
March 2, 2026 - March 27, 2026 |
| Glendon Way |
March 9, 2026 - April 3, 2026 |
| Arroyo Verde Road |
March 23, 2026 - April 17, 2026 |
|
| December 2025 - May 2026 |
Concrete Improvements
Impacted Streets
| Edgewood Drive |
February 9, 2026 - February 13, 2026 |
| Milan Avenue |
February 12, 2026 - February 20, 20226 |
| Oneonta Knoll Street |
February 23, 2026 - March 6, 2026 |
| Maple Street (East) |
March 9, 2026 - March 20, 2026 |
| Pine Street |
March 23, 2026 - April 10, 2026 |
| Maple Street (West) |
March 27, 2026 - April 16, 2026 |
| Glendon Way |
April 6, 2026 - April 17, 2026 |
| Arroyo Verde Road |
April 20, 2026 - May 1, 2026 |
|
| January 2026 - May 2026 |
Asphalt Improvements
Impacted Streets
| Mill Road |
February 23, 2026 - February 27, 2026 |
| Edgewood Drive |
February 23, 2026 - February 27, 2026 |
| Milan Avenue |
February 23, 2026 - February 27, 2026 |
| Oneonta Knoll Street |
April 27, 2026 - May 8, 2026 |
| Maple Street (East) |
April 27, 2026 - May 8, 2026 |
| Maple Street (West) |
May 4, 2026 - May 8, 2026 |
| Pine Street |
May 4, 2026 - May 8, 2026 |
| Glendon Way |
May 6, 2026 - May 8, 2026 |
| Arroyo Verde Road |
May 11, 2026 - May 15, 2026 |
|
|
**Schedules are subject to change due to weather conditions or other unforeseen factors. If construction work does not occur on the posted date, the work will be rescheduled, and new signs will be posted.**
|
| PRESENTATION |
September 8, 2025 Town Hall Meeting Presentation Link
FY-25-26-Street-Improvement-Project-Presentation.pdf(PDF, 2MB)
|
| QUESTIONS? |
For any questions related to the project, please reach out to Project Manager Michael Vartanians mvartanians@southpasadenaca.gov.
|
